Fugro Executes First Part of Rampion Cable Laying Campaign

Fugro said it has completed ‘phase one’ of cable laying operations on schedule at the Rampion offshore wind farm, as the programme takes a break over winter.

The installation of 60 cables was completed at the end of October – three more than the 57 cables originally planned.

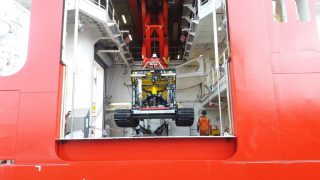

Subsea construction vessel Fugro Symphony started site operations in August, having transported some 75 kilometres of cable to the Rampion site, off the UK’s Sussex coast, on its 2000t carousel. Sister vessel Fugro Saltire completed cable burial in November using Fugro’s Q1400 subsea trenching system.

Both vessels will return next spring, complete with Fugro’s full cable installation equipment spread, to install the remaining 62 cables in phase two. Completion is expected by summer 2017.

Mike Daniel, business manager for construction at Fugro Subsea Services, said: “The cable laying operation at the Rampion site shows the successful integration of our trenching services with full subsea cable installation for offshore wind farm developers. We have been particularly satisfied with the performance of the new track base unit we developed for our FCV deepwater ROVs.”

Share this article

Follow Subsea World News

Events>

<< Dec 2019 >>
MTWTFSS
25 26 27 28 29 30 1
2 3 4 5 6 7 8
9 10 11 12 13 14 15
16 17 18 19 20 21 22
23 24 25 26 27 28 29
30 31 1 2 3 4 5

M&CCE Expo Marine & Coastal Civil Engineering 2020

This conferences, events, demos, and competitions provide a productive background buzz throughout M&CCE…

read more >

Underwater Intervention (UI) 2020

Underwater Intervention Conference is a conference where oil and gas industry professionals, senior decision…

read more >

Subsea Expo 2020

Subsea Expo is the world’s largest subsea exhibition and conference and is completely free to attend.

read more >

Oceanology International 2020

Exhibitors from industry, government and research institutions share their knowledge and come…

read more >
